Enterprise
Water Treatment Technologies

Practical guidance for better product and service decisions.

Purified Water Equipment Process Flow: Stages, Equipment Logic & Operational Boundaries

Published: 2026-07-16

Who This Applies To

This process flow explanation is designed for procurement managers, plant engineers, and operations leads evaluating purified water equipment for beverage, food, pharmaceutical, or industrial applications — particularly those sourcing from manufacturers in China’s Guangdong province. It reflects actual configurations used in Chuxin Mingwei’s fully automatic bottled purified water filling production lines (Product ID #59) and barrelled purified water systems (Product ID #54), both built around dual-stage reverse osmosis (RO) core purification.

Why Process Flow Matters — Beyond the Schematic

A purified water system isn’t a sequence of boxes on a diagram. Its stability, long-term maintainability, and regulatory readiness depend on how stages interlock — especially under variable source water conditions. For example, without proper pre-treatment matching (e.g., multi-media + activated carbon + softening), RO membranes foul faster, increasing downtime and replacement cost. Likewise, omitting ozone + UV (254 nm) sterilization after RO — as standard in Chuxin’s purified water lines — risks microbial regrowth in storage and distribution loops.

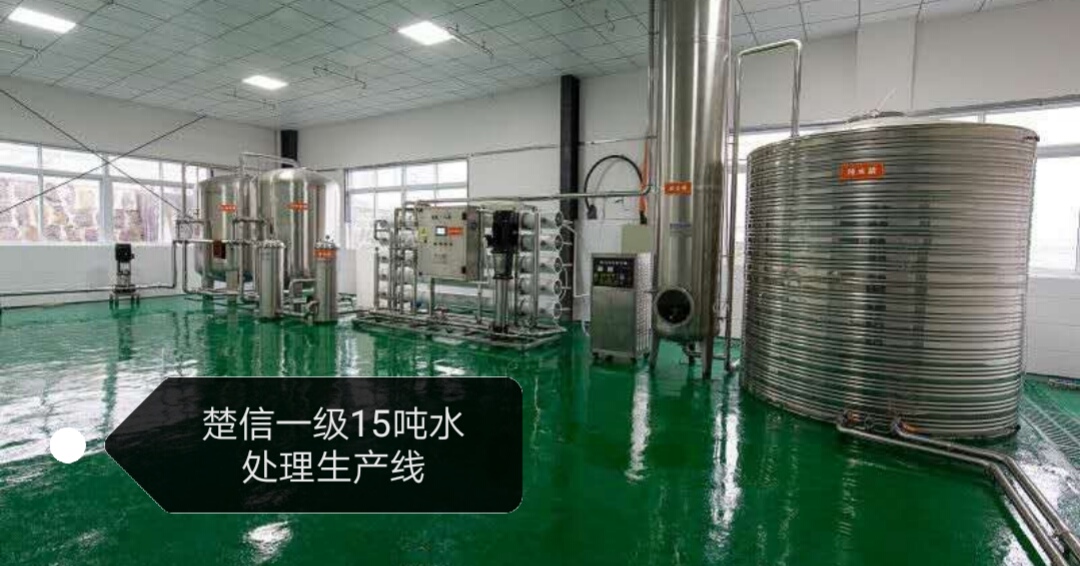

Core Process Flow: Five Integrated Stages

  1. Raw Water Pre-Treatment
  • Purpose: Remove suspended solids, chlorine, organics, hardness, and fine particles that damage RO membranes or compromise final quality.
  • Typical configuration: Multi-media filter → activated carbon filter → water softener → 5 µm保安 filter.
  • Boundary note: Pre-treatment must be calibrated to your original water report — not generic assumptions. TDS, hardness, iron/manganese, and turbidity directly determine filter sizing, resin type, and chemical dosing (e.g., antiscalant, pH adjuster).
  1. Dual-Stage Reverse Osmosis (RO)
  • Purpose: Achieve deep desalination and consistent low-conductivity output (<10 µS/cm typical), required for purified water standards (e.g., GB 17323, USP Purified Water).
  • Equipment logic: First-stage RO removes ~95–98% of dissolved salts; second-stage further reduces conductivity and ensures robustness against feed fluctuations. Each stage includes high-pressure pump, membrane housing, flow/pressure instrumentation, and CIP-ready design.
  • Operational boundary: Recovery rate (typically 50–75%) must balance water efficiency with scaling risk — determined by source water LSI/S&DSI indices, not preset defaults.
  1. Post-RO Disinfection & Polishing
  • Purpose: Prevent microbial proliferation post-membrane, where nutrient-poor but biologically active water can support biofilm growth.
  • Standard configuration: Ozone generator + mixing contact tank → UV sterilizer (254 nm wavelength) → 0.22 µm terminal filter.
  • Evidence-based note: In Chuxin’s field-deployed systems, this dual-barrier approach achieves ≥4-log reduction of bacteria and eliminates need for frequent hot-water sanitization — critical for continuous operation in food-grade environments.
  1. Storage & Distribution Loop
  • Purpose: Hold treated water while maintaining microbiological integrity and pressure stability for downstream filling.
  • Key components: Stainless steel sanitary water tank (with spray ball & vent filter), constant-speed or VFD-controlled booster pump, recirculation loop with temperature monitoring and UV re-circulation.
  • Boundary reminder: Tank volume must match peak hourly demand plus
  • buffer for RO downtime (e.g., 1.5–2× hourly capacity). Loop velocity (>1.0 m/s) and slope are non-negotiable for preventing stagnation.
  1. Filling Integration (Bottled or Barrelled)
  • Purpose: Transfer purified water into final packaging without recontamination.
  • Implementation logic: For bottled lines (e.g., Product #59), purified water feeds a PLC-controlled washing-filling-capping unit with ≤±2 mL filling accuracy. For barrelled lines (e.g., Product #54), it supplies a wash-fill-seal system with triple-layer disinfection (internal wash + ozone + UV) validated per SC-compliant SOPs.
  • Critical interface: Water supply pressure, flow consistency, and air-free delivery must align with filling machine specs — mismatch causes fill variation, foaming, or cap seal failure.

What’s Not Included — And Why

This flow does not cover ultra-high-purity applications (e.g., EDI, mixed-bed polishing), which fall outside standard purified water scope and require separate design (see our Electronics or Pharma-specific guides). Nor does it assume shared water treatment between bottle and barrel lines — co-use is possible only if both lines operate synchronously, share identical quality targets, and include independent final filtration and sterilization before each filling point.

Purified Water Equipment Process Flow: Stages, Equipment Logic & Operational Boundaries

Next Step: Validate Your Specific Flow

Before finalizing layout or budget, confirm:

  • Your original water test report (TDS, hardness, Fe/Mn, SDI, microbiology)
  • Target output standard (e.g., GB 17323, FDA 21 CFR Part 129, internal spec)
  • Hourly production rate and shift pattern
  • Available floor space, power supply (voltage/frequency), and drainage capacity

Chuxin Mingwei engineers use these inputs — not generic templates — to configure your exact process flow, equipment list, and installation plan.

Ready to Align Your Requirements?

Share your water source, target standard, capacity, and facility constraints. We’ll deliver a validated process flow diagram, equipment specification sheet, and implementation timeline — within 5 working days.
